WORKPLAN

Jewett School Forest Treatment Rehabilitation Project

Latest page update: July 1, 2026

Timeline and Hours of Work:

Next Work Date:

  • Thursday, July 2, 2026

  • Loki crews meet on site at 08:00

  • BCWS crews expected for ETA 09:30

  • BCWS crews depart site at 14:30

  • Loki crew depart site at 15:30

Transportation Plan:

For Thursday July 2

  • Auri and Dimo to carpool from Nelson - travel status from Kaslo - submit fuel receipts.

  • Jake travelling in chipper rig

  • BCWS crews travelling from base

Location:

Jewett Elementary School

  • From Kaslo, drive north on Hwy 31 for approximately 40km until you reach the village of Meadow Creek. Look for Meadow creek Road on your left. Drive for approximately 350m and find Jewett School on your right.

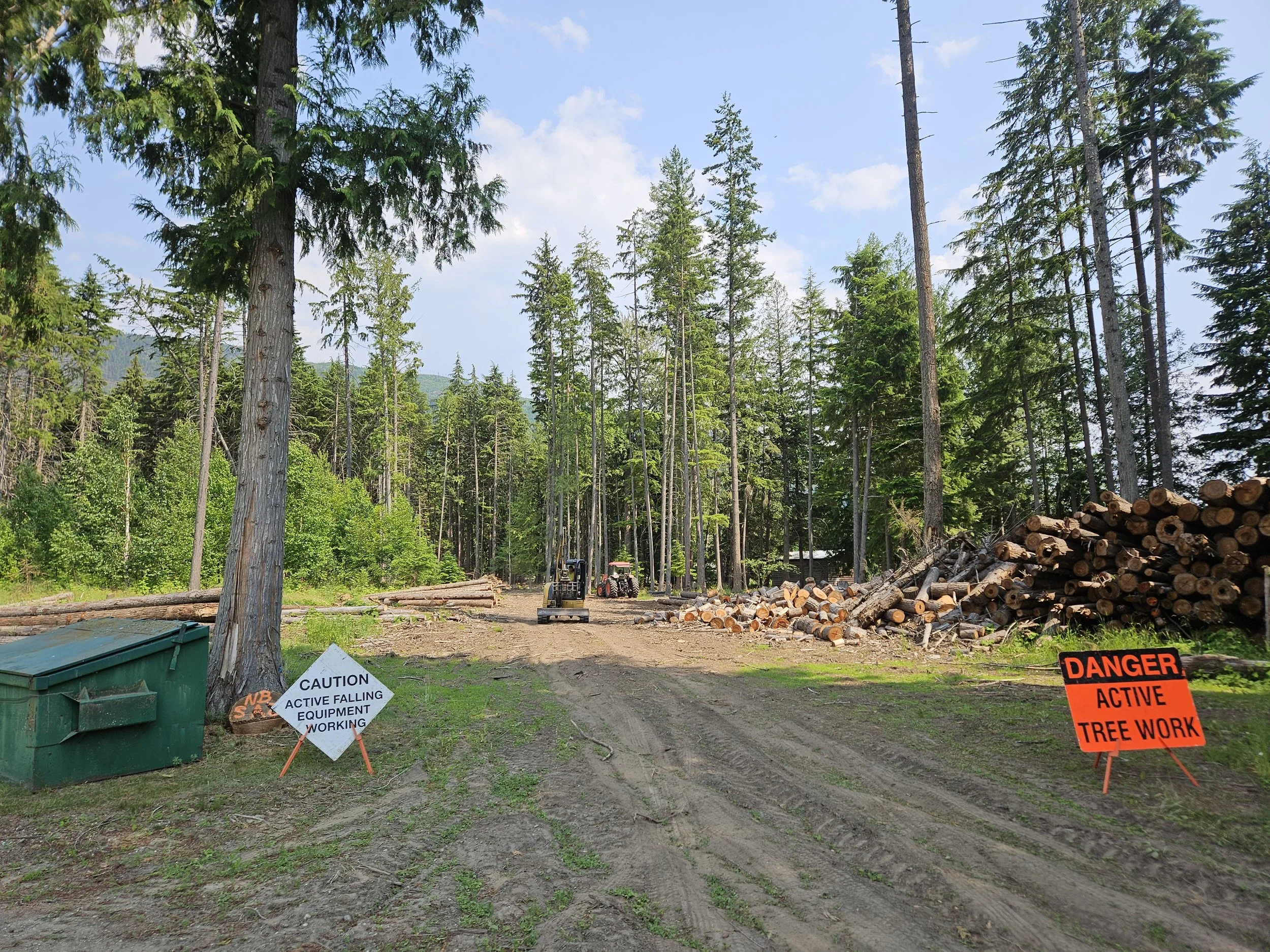

Site access:

  • Main gate will be closed at all times when school is not in session.

  • Signage and barricades surrounding forest will indicate work area.

  • Contact Jake or Clinton on LD1 for site access.

Communications:

Worksite Radio Channel: LD-1

  • No cell reception

  • InReach Satellite Device is with OFA equipment

Work Plan

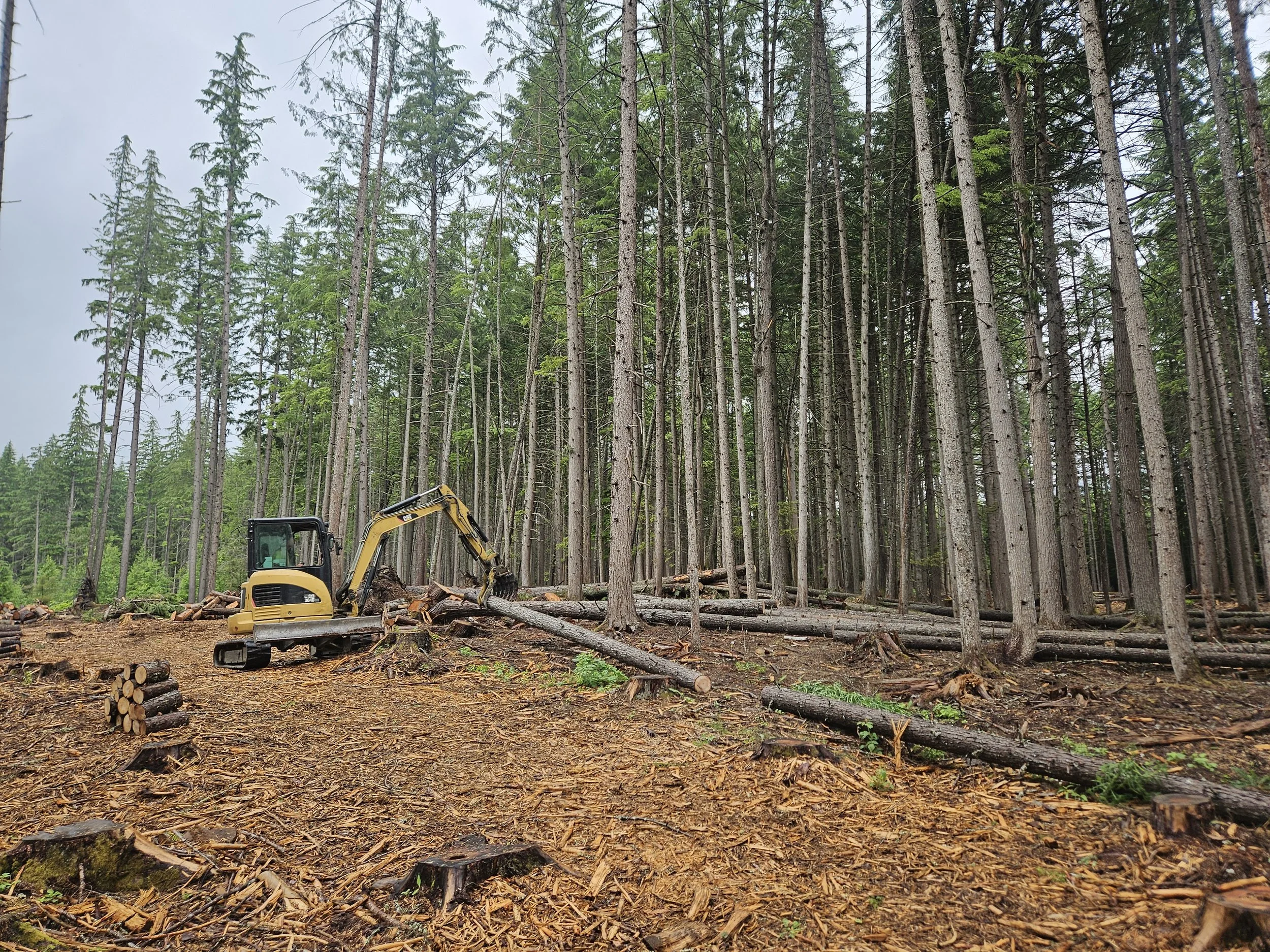

Equipment:

  • Caterpillar 3.5 ton mini-excavator / 14’ dump trailer

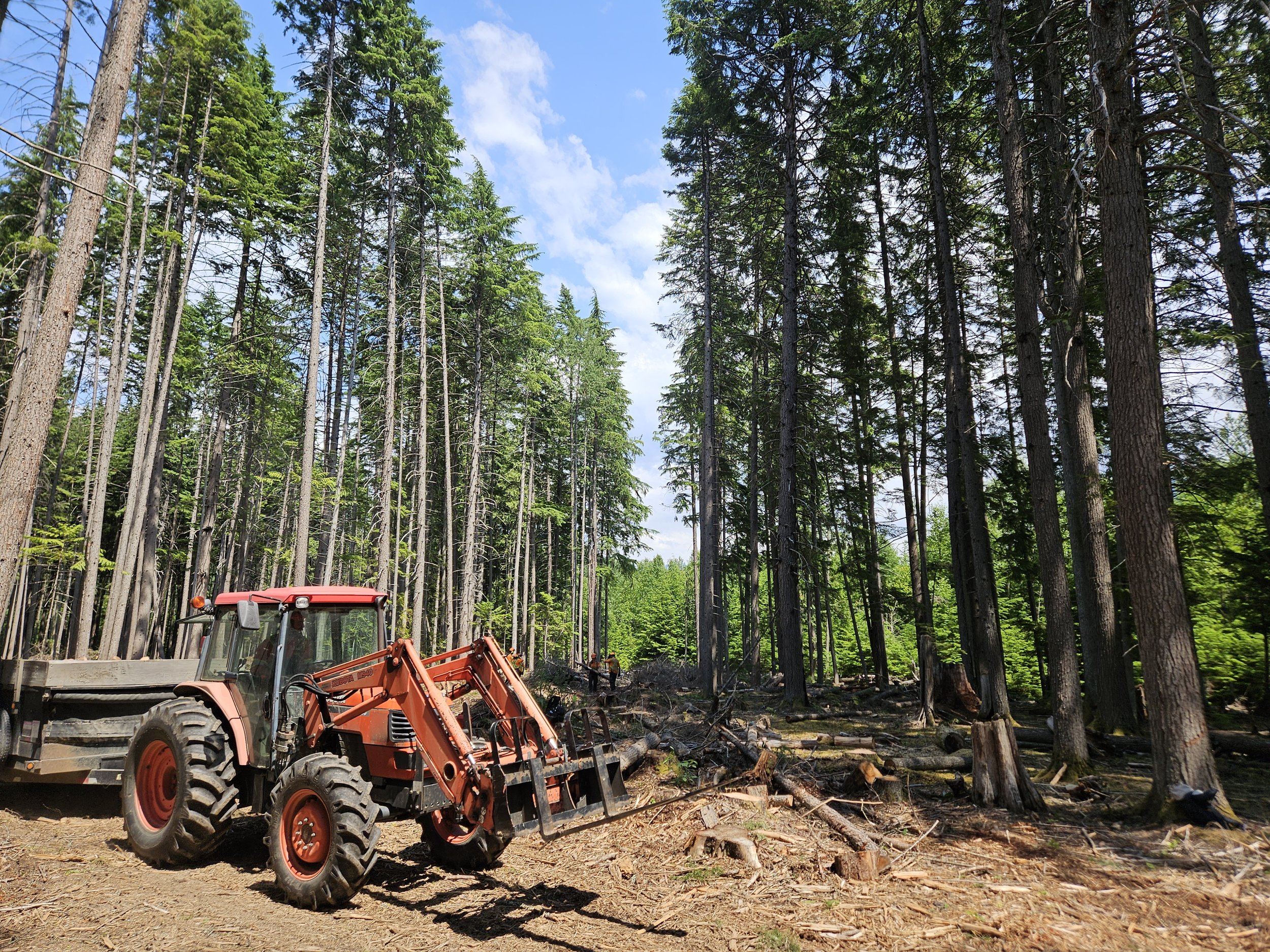

  • Kubota Tractor Forwarder / Self-loading trailer

  • BC1200XL Wood chipper / 1-ton dump truck

  • Pioneer 520 UTV

  • Self-Loading Log Truck / Short hauler

The complexity of this project will require the integration of phases.

BC Wildfire Service Crews - July 2 + 3 - Link to Work Plan

Loki Tree Service Crew - July 2 + 3 - Link to Work Plan

Phases:

Firewood

  • One of the higher value products we have the opportunity to produce from this project is firewood.

  • We wish to prioritize the forwarding and decking of logs from the back end, as much as possible.

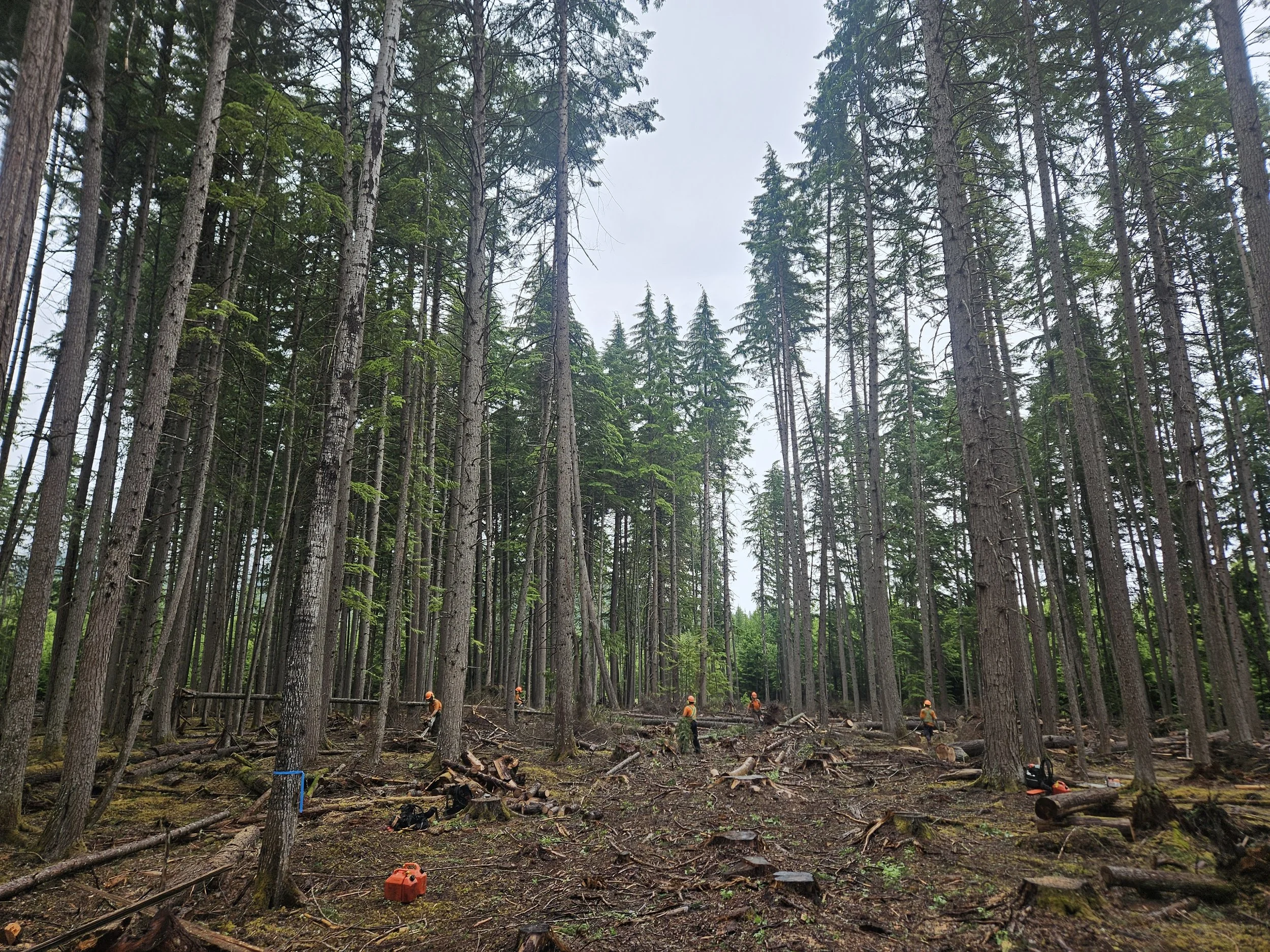

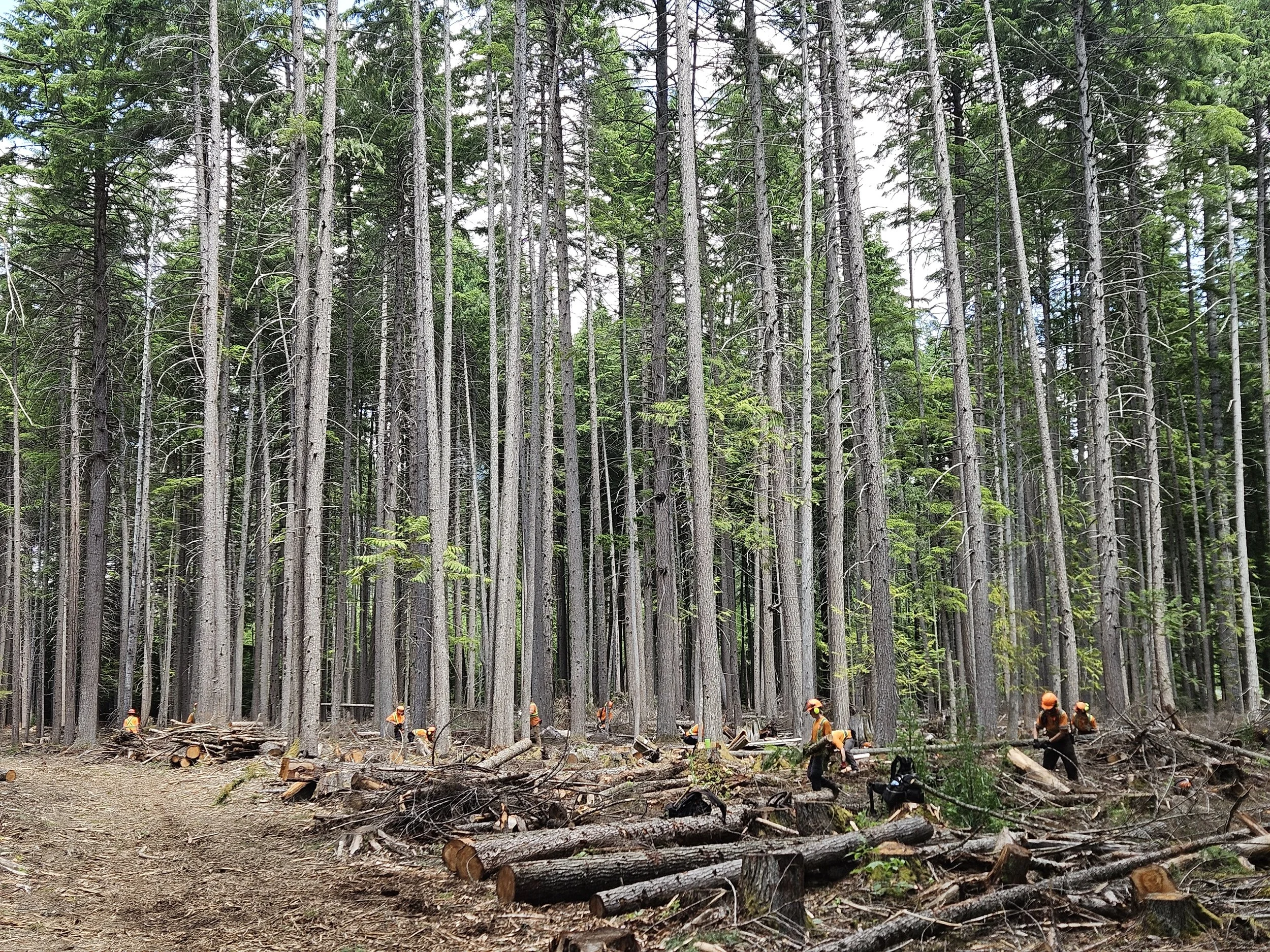

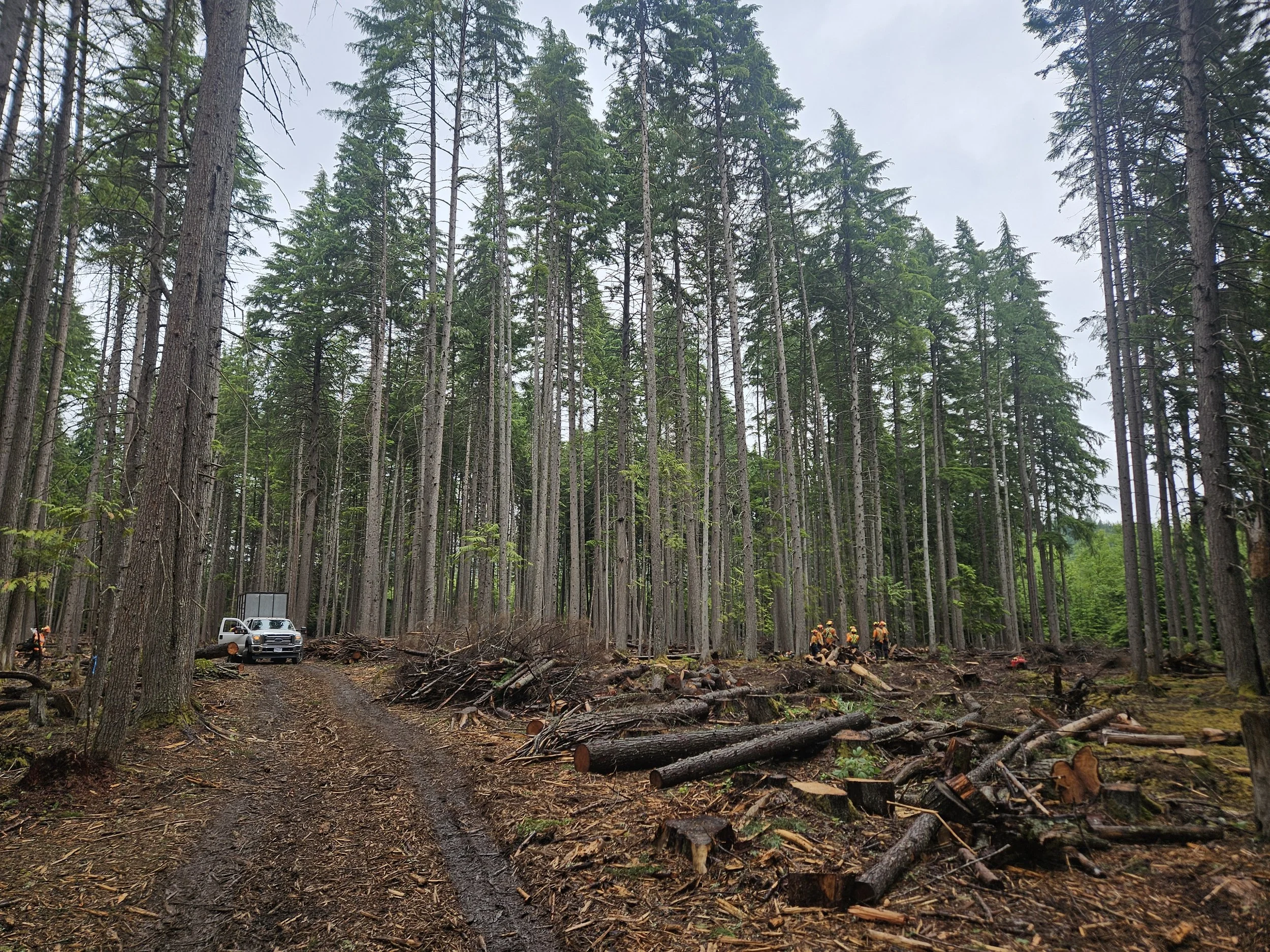

  • Crews will work highest density areas first.

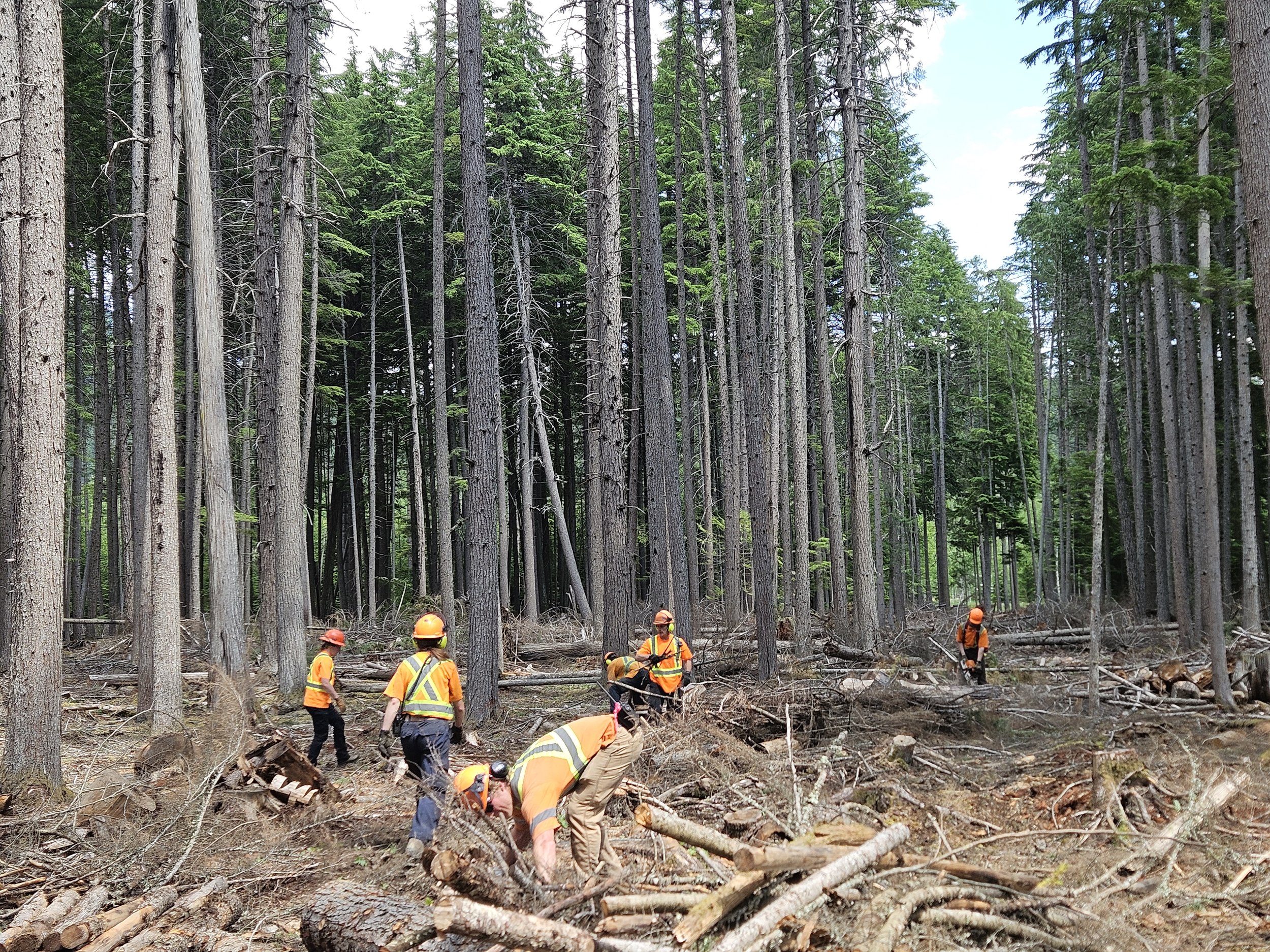

  • Crew activities will involve processing logs and windthrow, prioritizing the production of firewood, and prioritizing longer lengths.

Mulch

  • Windthrow events and pre-existing material on the ground has necessitated the use of a commercial wood chipper on site.

  • As firewood is being processed, limbs, tops, skidded material, and forest debris will be piled as feed-piles for chipping.

  • Staged feed piles will be chipped by hand into the 4x4 dump truck.

  • Mulch deliveries will leave the site throughout the day.

Waste

  • As crews work their general areas, they will encounter upturned roots, cut stumps, and other forest debris classified as waste.

  • Material fitting this description will be piled by crews among the existing clumps of root-wads for transport to a burn-pile off site.

Forwarding

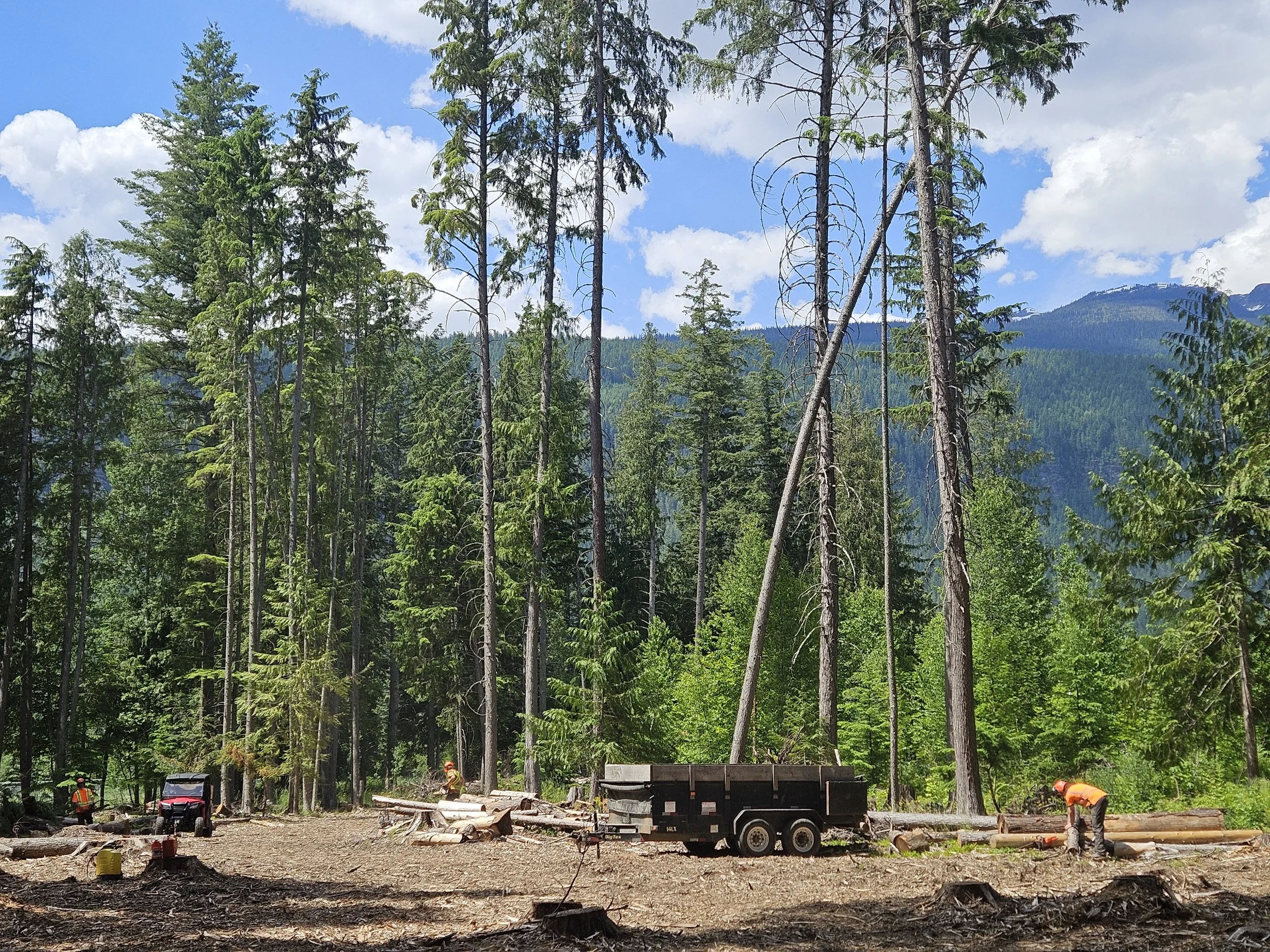

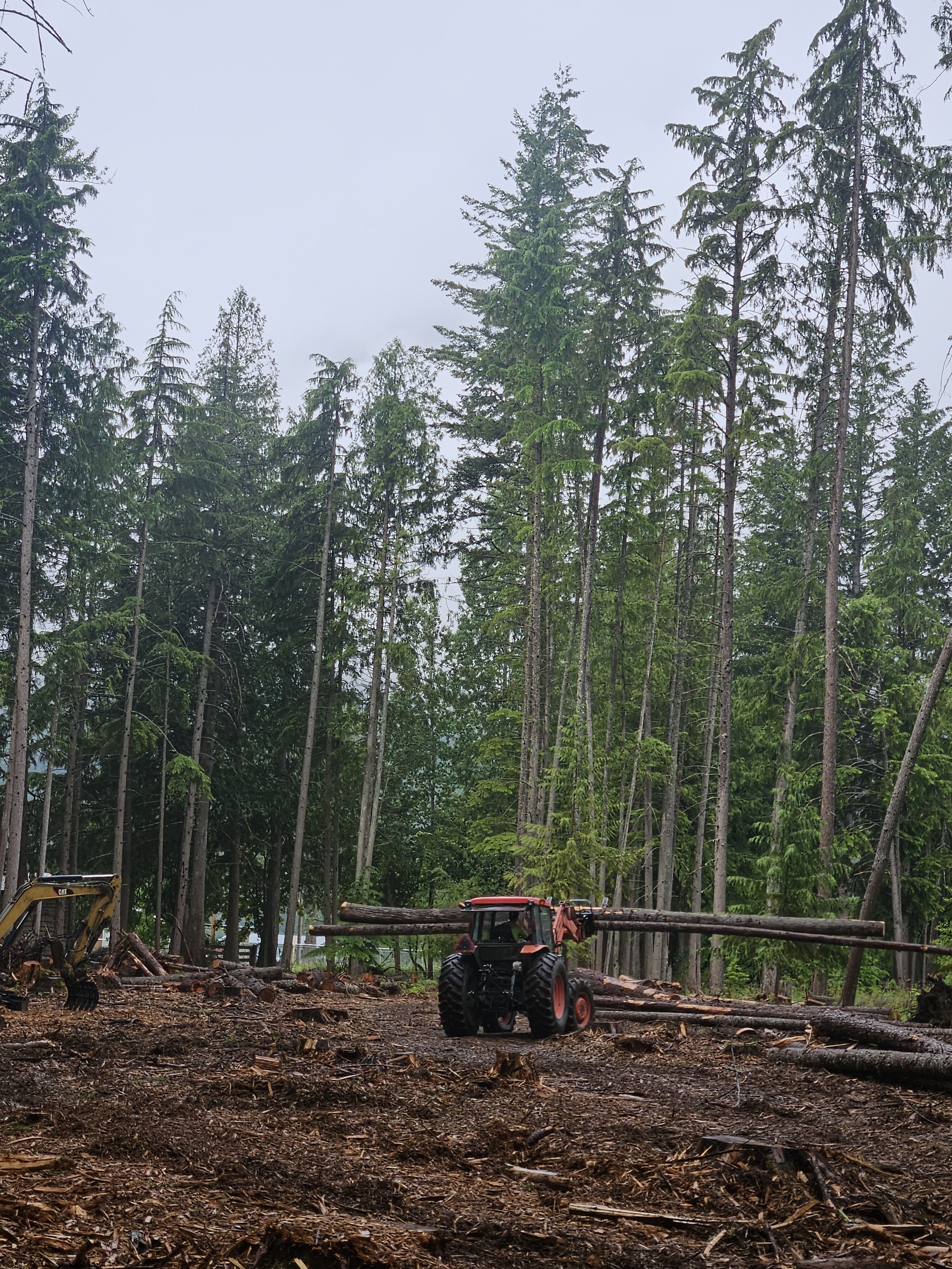

  • Excavator and UTV forwarding root wads, odd shaped stumps, random chunks to areas where the dump trailer can access.

  • Tractor/self-loader trailer forwarding logs and good firewood to the landings which the log truck can access. (See Map)

  • Chainsaw crews will process, rig, and yard smaller material to forward locations for chipping and for log hauling.

    loading and sort locations - map

Hauling

  • Forwarded material will ensure enough bunk logs to build loads and haul various lengths. As much as possible, good wood from the back 40 will be forwarded to areas the log truck can access.

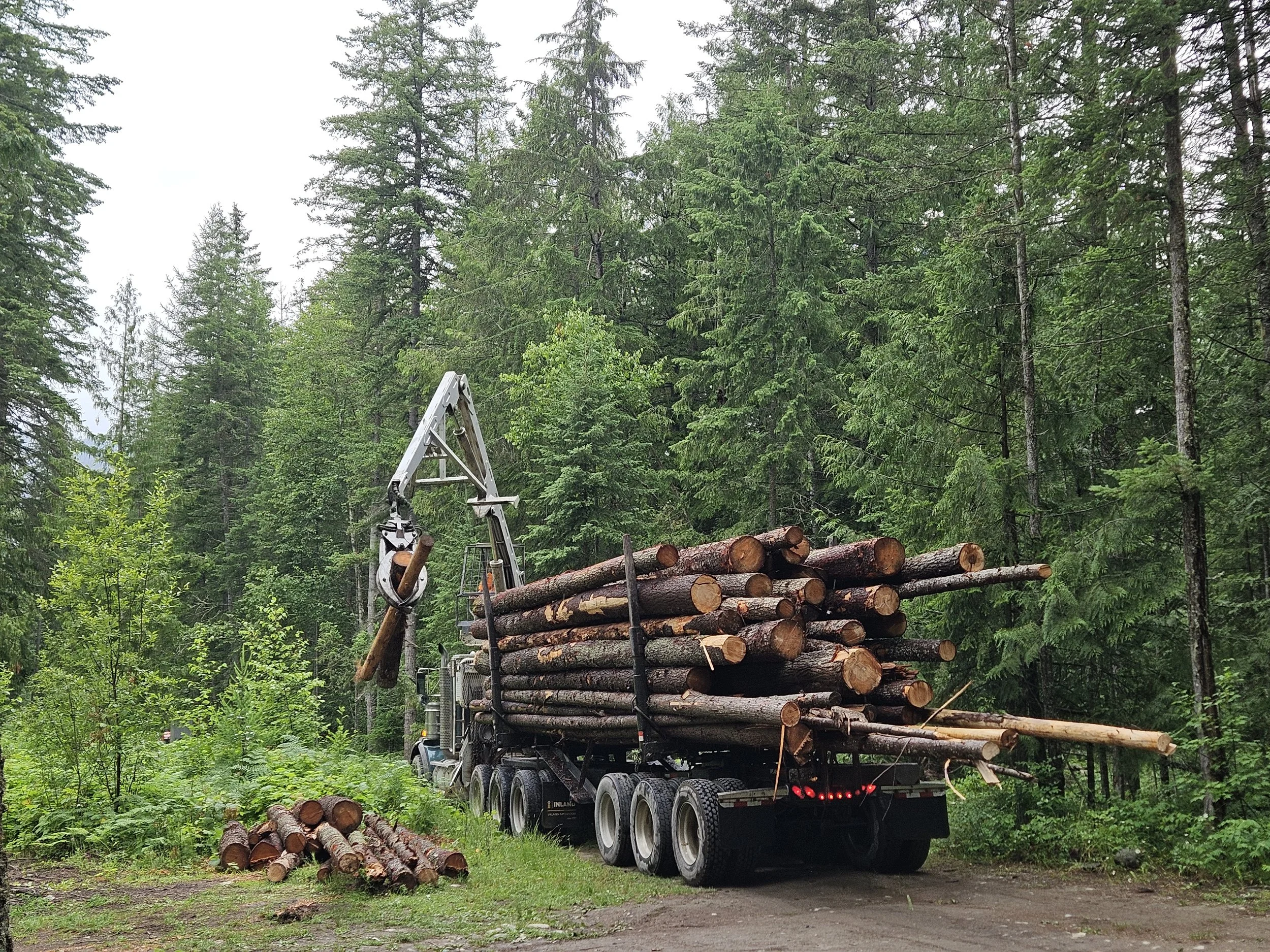

  • The large diameter cut cedar stumps, uprooted stumps, and root wads will be hauled using the dump trailer

  • Branches and smaller material that is dragged and winched to the access points will be chipped by hand into a 4x4 dump truck and chips will be hauled off site.

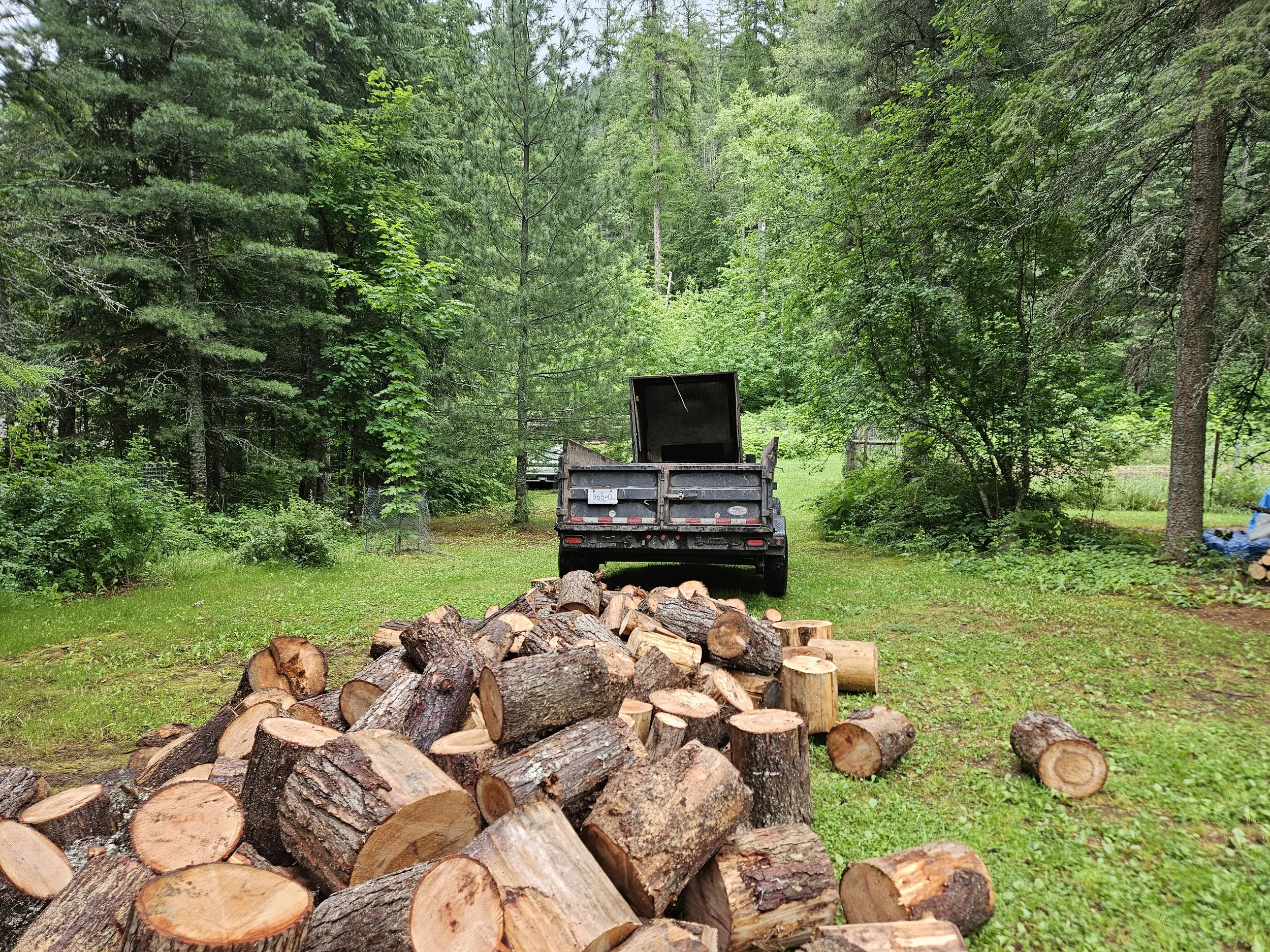

  • Firewood which cannot meet length requirements of log truck will be hauled in 16” lengths using the dump trailer.

Firewood Delivery List

Clint Carlson log sort - map

Treatment Area - Map

Site Rehab

  • Loading and landing areas will require some blade work.

  • Landing and winching areas will require some raking of small material damaged by earlier skidder operations.

  • Heavy mulch areas (skid trails) will require raking and possibly some loading and hauling.

  • Consideration for maintenance and proliferation of mossy areas, lichens, native grasses.

  • Discussion about future of site / wind-firmness will be required.

Contacts:

Land-Owner:

School District 8: Chris Kerr -

Supervising Consultant:

Cathro Consulting: John Cathro + Mark Elder

250 505 3513

Prime Contractor:

Loki Tree and Forest Service: Jake Roos

250 814 8855

Equipment Supervisor:

Clinton Syfchuck

250 551 4746

Crew Members:

Shane Lanthier (alternate supervisor) - 250 946 6056

Auri Thayer - 250 354 8326

Kale Gerhmann - 250 505 2341

Dimo Vrac - 778 392 5145

First Aid Plan

  • Jake Roos: Advanced OFA Attendant

  • Auri Thayer: Advanced OFA Attendant

  • Kale Gerhmann - EMR Attendant

  • Clinton Syfchuck: Basic First Aid with Transport Endorsement

  • Level 3 Kit w 02, Blankets, and Stretcher Kit is found at main staging

Please use the following links to find updated site documents:

Emergency Response Plan

First Aid Assessment Worksheet

Georeferenced Map

Pre Work Meeting

Notice of Project

Site Hazard Assessment Form

Daily Meetings

Danger Tree Assessment

Timbermark

Confirmation of Insurance (incl. additionally insureds)

WCB Clearance Letter

Progress Photos


What to Bring:
